How to Enter the Ukrainian Defence Market in 2026: A Guide for International Defence Companies

Randoms

Ruslana Safina

A foreign defence company can spend a year in Ukraine, collect useful feedback and still make no Ukrainian revenue.

That is not necessarily a failure. It may be the right result. The mistake is calling validation, sales and localisation the same thing.

There are four routes into Ukraine's defence market in 2026. They have different buyers, budgets and returns. The cheapest starts below USD 1 million. The deepest starts at USD 6 million and takes 12 to 24 months.

Choose the return before you choose the contact.

We know why this distinction matters. DARC is a team founded by Ukrainians. We bring international manufacturers into Ukraine and help Ukrainian companies enter allied markets. That puts us in calls with foreign manufacturers, Ukrainian companies and the institutions between them.

From that position, a signed memorandum looks different. It usually means the hard work is about to start.


How can an international defence company enter Ukraine in 2026?

The short answer is a five-stage sequence:

  1. Decide whether you need validation, Ukrainian revenue or local production.

  2. Test the product through Brave1 and define the evidence you need.

  3. Put engineers close to Ukrainian operators and rebuild what fails.

  4. Create the legal and commercial structure needed for a sale.

  5. Localise only after the product has repeat demand.

Defence City and export planning come later. Neither should be the first slide in a market-entry plan.

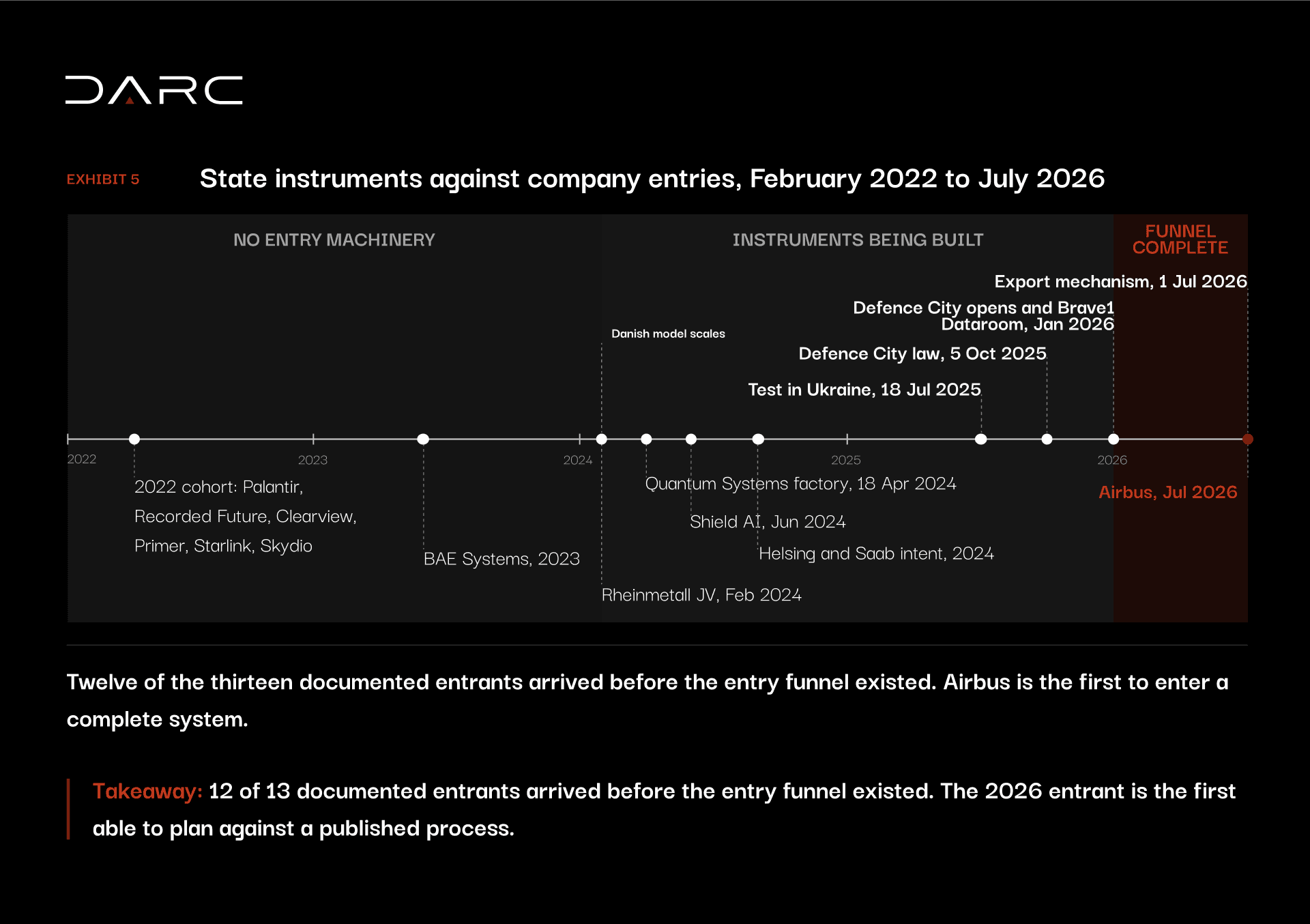

This answer comes from DARC's review of 13 documented foreign entrants between February 2022 and July 2026. Twelve entered before today's funnel existed. Airbus, in July 2026, was the first major entrant able to use the complete published process.

What this means for your business: do not copy a 2022 entry story. Personal access filled a gap because the formal routes did not exist. A 2026 entrant can plan the sequence.

Sources: DARC cross-case analysis; Cabinet of Ministers of Ukraine; Law No. 4577-IX; Airbus and Brave1 entry record cited in DARC Research.


What are the four routes into the Ukrainian defence market?

The first decision is what Ukraine should return in the first 12 months.

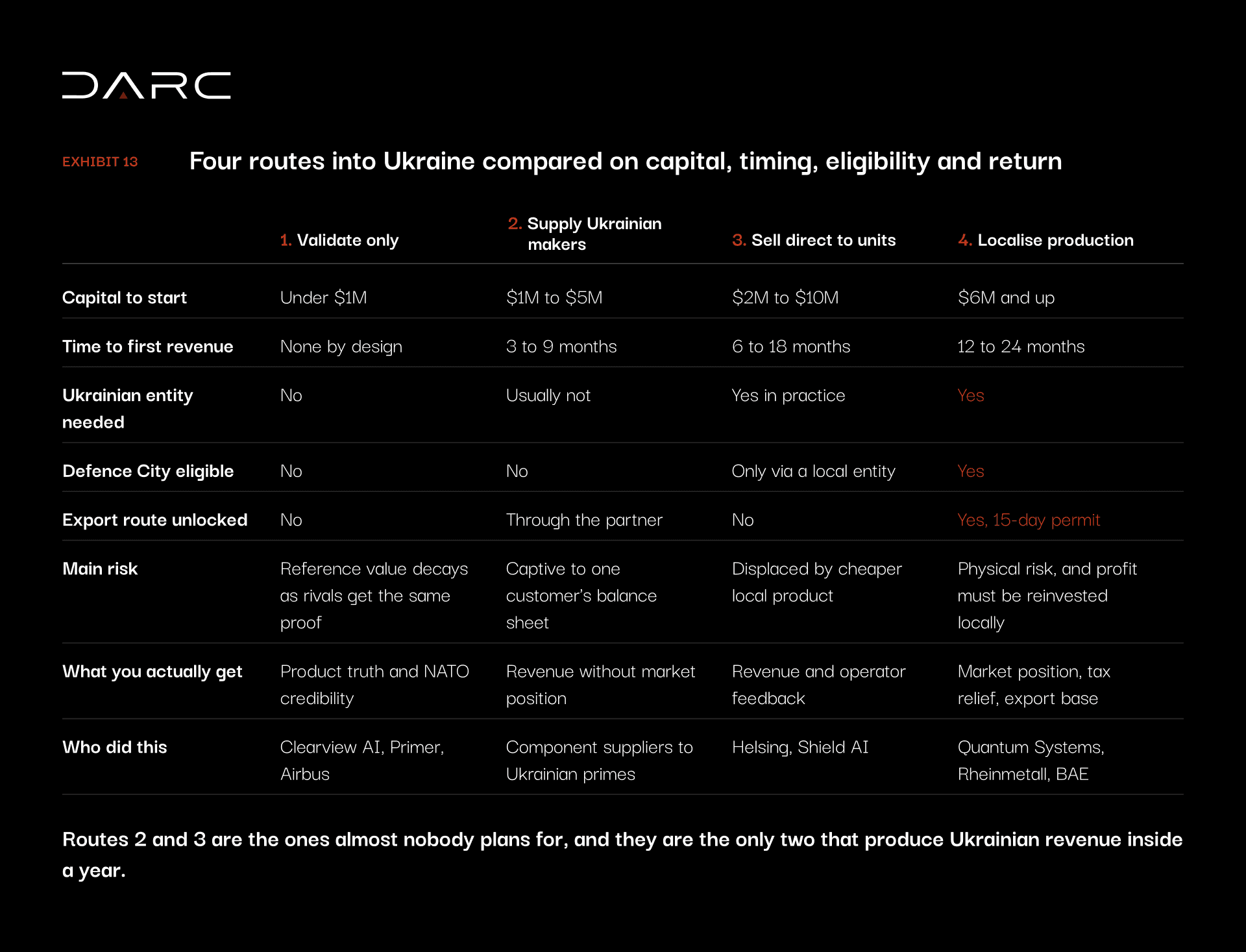

Route

Capital to start

First Ukrainian revenue

Ukrainian entity

What the company gets

Validate only

Under USD 1m

None by design

No

Product truth and credibility in NATO markets

Supply Ukrainian manufacturers

USD 1m to USD 5m

3 to 9 months

Usually not

Revenue without a full local operation

Sell direct to military units

USD 2m to USD 10m

6 to 18 months

Yes in practice

Revenue and operator feedback

Localise production

USD 6m and up

12 to 24 months

Yes

Market position, incentives and an export base

We derived these analytical ranges from documented cases. They are not government fees, official thresholds or guaranteed timelines.

Route 1 is fast to start. It produces no Ukrainian revenue by design. Clearview AI, Primer and Airbus followed versions of it.

Route 2 serves a Ukrainian manufacturer instead of building a full domestic operation. It can return revenue in three to nine months.

Route 3 connects a verified product to units and state payment. Helsing and Shield AI show versions of this path, although Shield AI's Ukrainian revenue is not public.

Route 4 creates the deepest local position. Quantum Systems, Rheinmetall and BAE Systems followed different versions of localisation.

Commercial implication: if the board expects Ukrainian revenue inside a year, plan around Route 2 or Route 3. A test alone will not deliver it.



How large is the market, and who actually buys?

The headline number is useful only when the category is clear.

The KSE Institute, working with Brave1 and Defence Builder, estimated a funded defence technology market of USD 6.8 billion in 2025. Unmanned aerial systems represented USD 6.3 billion, or 93 percent.

That concentration changes the entry question. A company outside the largest funded segment should not treat USD 6.8 billion as its addressable market. Its direct customer may be a Ukrainian manufacturer buying a subsystem, component or software layer.

There is also no single Ukrainian defence customer. The operator, buyer, contract signer and payer may be four different parties.

DOT-Chain Defence is the fastest documented route from a verified listing to a military unit. The product is selected, a brigade commander approves the order, and the Defence Procurement Agency contracts, pays and monitors delivery.

In under five months of 2026, DOT-Chain moved UAH 31.4 billion and 485,000 systems. It listed about 800 items from more than 200 Ukrainian manufacturers and reached 130 frontline brigades. Advance payments were available to effective drone manufacturers.

Other payment routes include central procurement, partner governments using the Danish model, and Ukrainian manufacturers purchasing foreign inputs.

Before we build an introduction list, we need four answers:

  1. Who operates the product?

  2. Who verifies it?

  3. Who signs the contract?

  4. Who releases the money?

For your business: a user asking for the product is demand evidence. It is not yet a purchase order. Map the payment chain before pricing the entry.

Sources: KSE Institute with Brave1 and Defence Builder, Ukrainian defence technology market report, 31 March 2026; Ministry of Defence of Ukraine and Defence Procurement Agency, DOT-Chain Defence materials, 2026.


Which Ukrainian entry mechanisms matter in 2026?

Four mechanisms now govern the practical route.

Test in Ukraine

Test in Ukraine opened on 18 July 2025. It received 45 foreign applications in its first month. No Ukrainian entity is required.

The company can run trials on site. It can also train Brave1 specialists and hand over the units for testing. Both routes produce a written report from testing with combat-experienced users.

The application resource named in the research is testinukraine.brave1.tech.

Build in Ukraine, Build with Ukraine and the Danish model

These mechanisms connect partner funding with production inside Ukraine or Ukrainian production abroad. They require a real industrial partner, committed capital and a defined production model.

Defence City

Law No. 4577-IX took effect on 5 October 2025. The regime opened on 5 January 2026. A complete residency application has a published decision period of 10 working days.

A foreign-incorporated company cannot qualify directly. It needs a Ukrainian legal entity. At least 75 percent of prior-year income must come from its own defence goods. The published threshold is 50 percent for aviation.

Advisers cited in the research differ on the exact scope of that 50 percent threshold. Confirm it before structuring. Profit receiving the exemption must be reinvested in Ukraine's defence sector. Annual reporting is required.

A company incorporated in 2026 will usually need qualifying revenue history first. In practice, 2027 is the first realistic residency year.

Controlled export

The state approved the export mechanism on 1 July 2026. Domestic military need comes first. Export still requires licensing, end-user documents and interagency review.

Defence City residents have a 15-day route for a preliminary export permit. This is not an automatic right to ship. Broader routes can take longer.

Your planning decision: test without incorporating. Incorporate for domestic contracts or production. Apply for incentives only after the entity has the required income history.

Sources: Cabinet of Ministers of Ukraine, Test in Ukraine launch, 18 July 2025, and export mechanism approval, 1 July 2026; Law No. 4577-IX; Cabinet implementing acts; Accace, Sayenko Kharenko and Baker McKenzie briefings; Lawfare; OSW Centre for Eastern Studies.


What does a workable entry sequence look like?

When we compare the cases, the same sequence keeps appearing: test, iterate, sell, localise and then optimise. Three companies show why the order matters.

Shield AI: the value came from eight months of rework

Shield AI entered in June 2024 with V-BAT units and engineers. The system became operational in August. The company then spent roughly eight months iterating against Ukrainian jamming.

It established a Kyiv operations team, hired Ukrainian veterans and worked with local users. By 17 April 2025, V-BAT had completed more than 130 sorties.

Here is the evidence boundary:

  • Verified: deployment and the sortie count.

  • Company claim: the stated performance effects.

  • Not disclosed: Ukrainian revenue.

Operational implication: budget the engineers and redesign cycle before shipping. The trial creates value only if your team can change the product.

Sources: Shield AI company release, 17 April 2025; Janes on operational status from August 2024.

Quantum Systems: localisation improved the product

Quantum Systems opened a Ukrainian factory on 18 April 2024. Planned investment was up to EUR 6 million over two years. The target was about 100 staff and 1,000 aircraft a year.

By May 2025, its Ukrainian CTO reported that all Vector fuselage components were made locally. Ukrainian engineering increased material strength and removed about 250 grams from the original specification. The facility network produced 40 to 80 Vector aircraft each month.

The public record does not disclose Ukrainian revenue.

Localisation decision: start with the work closest to the feedback loop. Local engineering should improve the product, not simply copy a foreign line.

Sources: Quantum Systems company releases; Militarnyi on the April 2024 factory and May 2025 local fuselage production.

Rheinmetall: an announcement is not capacity

Rheinmetall formed a 51 percent joint venture with Ukroboronprom in February 2024. The joint venture and contracts are verified. A vehicle line was operating.

Its ammunition plant was contracted in July 2024 with a 24-month target. Construction had not started by January 2026, according to Defense Express. Rheinmetall cited bureaucracy and a later site change. The same company built a German plant in 15 months.

  • Verified: the joint venture and contracts.

  • Reported: the construction delay and reasons, via Defense Express.

  • Not disclosed: Ukrainian revenue beyond the reported contract information.

Timeline implication: set the localisation schedule around site selection and permits. Do not use a memorandum date as the start of production.

Sources: Rheinmetall joint venture announcement, February 2024; Defense Express on plant status, delay reasons and comparative build time.



What did Adam Bry's warning reveal about foreign products?

Shipping a finished product and waiting for Ukraine to accept it is a poor entry strategy.

In the Wall Street Journal on 10 April 2024, Skydio CEO Adam Bry described a damaging reputation. US drones in Ukraine were seen as working less well than other systems. The research links the problem to high cost, glitches, repair difficulty and vulnerability to jamming.

The lesson is not that foreign products cannot work. Shield AI and Quantum Systems show that they can. The difference is whether engineers stay inside the learning loop.

Engineering implication: a failed field test is product evidence, not a verdict on Ukraine. Decide in advance who can repair, rebuild and retest.

Source: Wall Street Journal, 10 April 2024, including Adam Bry's statement, as reported by the Kyiv Independent.



Do hardware and software companies enter differently?

Yes. A software company should not inherit a factory entry plan.

Requirement

Hardware and manufacturing

Software and dual-use platforms

Ukrainian entity

Required for Defence City and domestic contracts in practice

Useful, but not required for initial deployment

Physical site

Plant, permits, protection and logistics

None

Main technical gate

NATO-style codification and operator verification

Compatibility with Ukrainian operational systems, including Delta

Indicative starting capital

USD 6m and up for localisation

Under USD 1m in documented cases

Timing

12 to 24 months for localisation

Weeks to months

Primary return

Revenue, local position and export base

Integration, reference value and product improvement

Delta was adopted across all levels of the Armed Forces in August 2025. It had already been tested for NATO interoperability at CWIX24.

Structure implication: hardware usually needs a sellable local structure. Software needs integration into the customer's operating environment before it needs a plant or export licence.


Sources: Ministry of Defence of Ukraine on Delta adoption; NATO CWIX24; DARC hardware and software case comparison.


Where do international entrants lose time?

The three expensive gaps sit between stages:

  1. Test to iteration: the product fails under electronic warfare, and management treats that as a market problem instead of a product defect.

  2. Iteration to sale: there is no Ukrainian legal entity or partner structure for a domestic contract.

  3. Sale to localisation: a memorandum is signed, but no capital is committed and no plant is built.

There is one operational rule behind all three. Send engineers before salespeople. Build the contracting route before promising revenue. Prove repeat demand before committing factory capital.

Where the public record stops, we stop. Shield AI and Quantum Systems disclose useful operating evidence, but not Ukrainian revenue. Rheinmetall's plant delay is reported, not independently verified in the research.

That discipline matters because a battlefield reference, a Ukrainian purchase order and an operating Ukrainian plant are three different results.


Frequently asked questions

Can a foreign defence company test in Ukraine without a local entity?

Yes. Test in Ukraine accepts international manufacturers without a Ukrainian entity. The company can join the test or train Brave1 specialists to run it.

Does a foreign company need a Ukrainian entity to sell?

For Defence City, local production and domestic contracts, usually yes in practice. A supplier to a Ukrainian manufacturer can often contract through that partner.

How long does market entry take?

Validation can begin in days to weeks. Supplying a Ukrainian manufacturer can return revenue in 3 to 9 months. Direct unit sales take an estimated 6 to 18 months. Localisation takes 12 to 24 months.

What is the fastest route to a first contract?

Once a product is verified and listed, DOT-Chain Defence or Brave1 Market can connect demand with state contracting. The company still needs codification and the correct contracting structure.

Can a foreign company join Defence City?

Not as a foreign-incorporated company. It needs a qualifying Ukrainian entity, the required prior-year defence income and a clean compliance record.

Can products made in Ukraine be exported in 2026?

Ukraine approved a controlled mechanism on 1 July 2026. Export depends on domestic needs, licensing, destination and end-user controls. Plan it as a second demand route, not an entry assumption.


Discuss your product with the DARC team: 30 minutes

Tell us your product category, readiness level and the result you need from Ukraine in the first 12 months.

In a 30-minute working call, we will map:

  • the entry route that fits the product;

  • the likely user, buyer and payer;

  • the first testing, partner or legal gate;

  • the point where the proposed timeline is likely to break.

No pitch. Just intel on your segment.

Summary

Entering Ukraine’s defence market in 2026 requires a clear market-entry strategy and an understanding of the routes available to international companies. From low-cost product validation to local production, this guide shows defence companies how to align their investment, timeline and commercial objectives with Ukraine’s emerging market-entry framework.

No pitch. Just intel on your segment.

Similar Articles
